EncapsulationOVERVIEW
Sometimes the safest move is to seal, not strip
Removing asbestos is not always the right answer. Where a material is in good condition and unlikely to be disturbed, taking it out can actually create more fibre-release risk, and more cost, than leaving it safely sealed. Encapsulation is the recognised alternative: coat, enclose or overboard the material so the fibres are locked away and the surface is protected.
Encapsulation is fully supported by HSE guidance for the right materials, sound asbestos insulating board, textured coatings, pipe insulation and similar. It is typically quicker, less disruptive and cheaper than full removal, with far less waste. The key is honest assessment: it is only the right call when the material is genuinely in good condition and in a low-disturbance location.
Innov8 UK Group assesses each material properly and will tell you straight whether encapsulation or removal makes more sense. Because we are a fully licensed removal contractor too, there is no bias, we recommend whatever is safest and most sensible, document it for your register, and can remove it later if the building ever changes.
METHODS
How we encapsulate
✓Sealant & encapsulant coatings
✓Overboarding of AIB & textured coatings
✓Enclosure & boxing-in of pipework

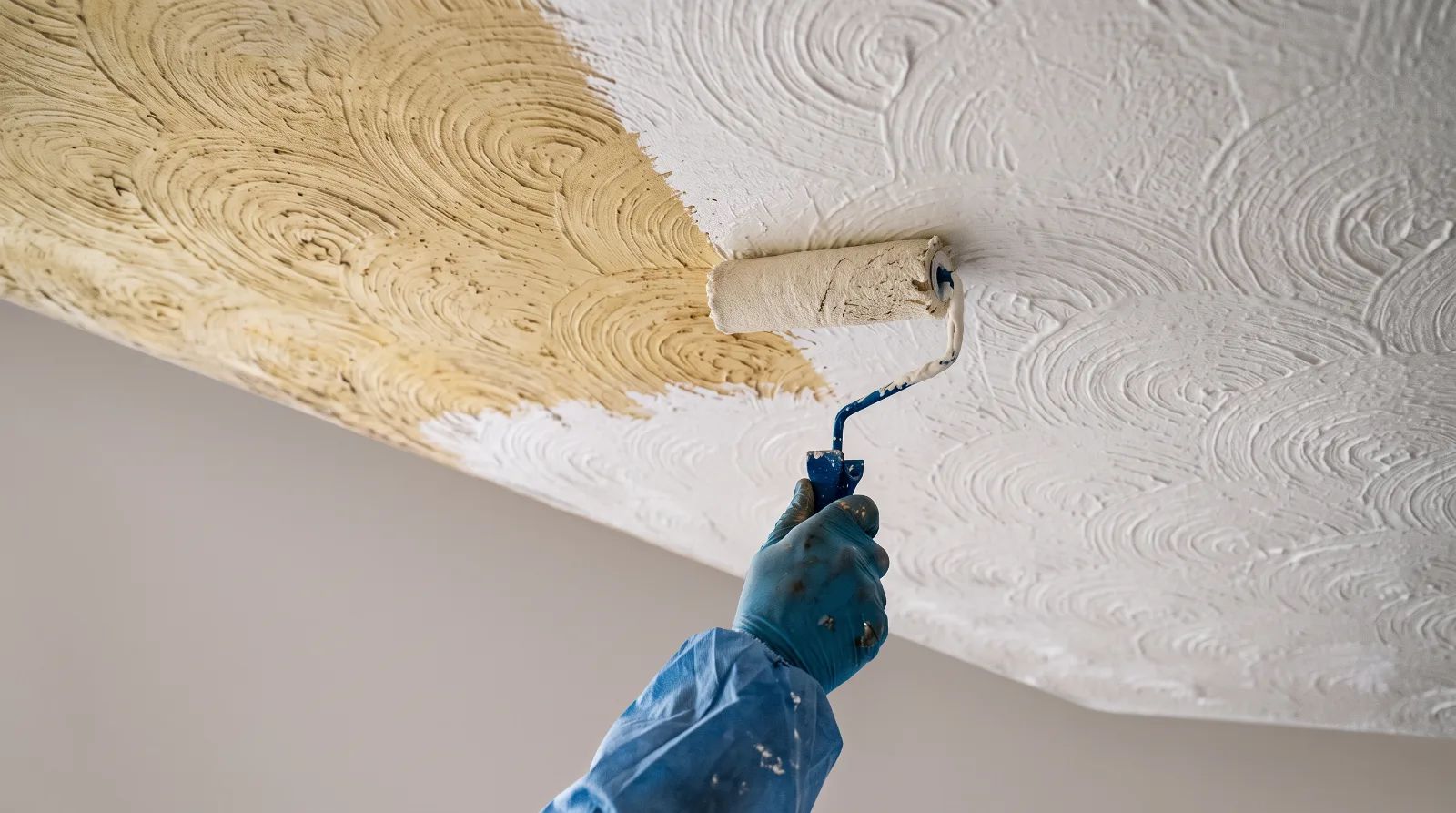

✓Skim-over of sound textured ceilings
✓Condition assessment before & after
✓Recorded on your asbestos register
✓Advice on remove-vs-seal decisions
✓Full removal available if preferred
Encapsulation in commercial & industrial buildings
In offices, factories and occupied commercial premises, sealing asbestos in place is often far less disruptive than removal — no strip-out, shorter programmes and the building keeps operating. We encapsulate ceilings, columns, risers and plant-room materials as part of planned refurbishments or ongoing management, with the condition recorded for your asbestos register and follow-up
air monitoring where needed. For larger works, see our
commercial asbestos removal service.
When encapsulation is the right answer — and when it isn't
Encapsulation suits asbestos that is in good condition, unlikely to be disturbed, and in a location where removal would cost more or create more risk than sealing it. A sound sprayed coating high in a plant room, AIB panels in a locked riser, lagging on a pipe run nobody will ever open up — sealing these in place controls the risk without the enclosures, downtime and cost of a licensed removal, and without disturbing fibre that is currently sitting quietly.
It does not suit damaged or deteriorating material, anything in a high-traffic or high-disturbance area, or material that refurbishment or demolition is about to disturb anyway — encapsulating a ceiling this year and cutting through it next year is money spent twice.
We will tell you when removal is the better answer, even though encapsulation is the cheaper job for us to win. That is the point of surveying before quoting: the recommendation follows the condition of the material, not the price list.
Where we encapsulate
The typical applications are consistent:
sprayed coatings to structural steelwork, where stripping would need extensive enclosure and the coating is doing its fireproofing job;
AIB in plant rooms and risers that is in good condition;
pipe insulation in runs too inaccessible to strip safely; and
asbestos cement roof sheeting, where a coating system extends the roof's life instead of replacing it.
Encapsulation is not the end of the duty
Encapsulated asbestos is still asbestos. It stays on the register, it stays in the
management plan, and it still needs re-inspection on a set cycle — because the encapsulation itself can be damaged, and a sealed panel that has been drilled through is no longer sealed.
What we hand over reflects that: a record of exactly what was sealed, where, with what system, and when it should next be checked, ready to drop into your register. The
duty to manage carries on; our paperwork makes carrying it straightforward.
Encapsulation or removal — how to decide
Five things settle it: the condition of the material, where it sits, how likely it is to be disturbed, what you plan to do with the building, and cost over time rather than cost this month. A
survey answers the first three, your plans answer the fourth, and our
costs guide covers the last. One visit, and you get a firm recommendation either way.
